Selected works
Lead Product Designer

Absorbing government data

Turning a 3–5 month partner data handoff into a self-service validation workflow

The Ground Truth Pipeline, Figma UI showing the submission lifecycle, pipeline gates, and decision points
Design process
I · Diagnose The 3–5 month wait
II · Map Eight stages, four themes
III · Reframe Feature to partnership
IV · Design Pipeline + clarity
V · Land Onboarding shipped
M · 01 The 3–5 month wait Every partner onboarding: emails, Excel schemas, manual reconciliation. No spec, no template.
M · 02 Eight stages of friction The current state surfaced where the work breaks — handoff, schema discovery, file format, resubmission.
M · 03 Four themes Same pattern across partners: no spec, 40-day black box, no agency-side ownership, zero reuse.
M · 04 Partnership reframe Not a CRUD feature. A partnership-scaling problem. Re-scope from forms to an onboarding pipeline.
M · 05 Read-only first Strategic scope. Ship visibility before edit. Earn trust before requesting mutation.
M · 06 Pipeline transparency Six stages, two decision points. Partners see exactly where their submission is in the pipeline.
M · 07 Ministry-admin clarity Designed for the ministry admin, not a data analyst. Clarity over density at every step.
M · 08 60 days → 2 weeks Onboarding compressed 4×. Email back-and-forth eliminated. Data team back on the model.
At a glance

From ~60 days to ~2 weeks per partner onboarding

Specifications shared up front and validation moved to upload, so partners arrive with the right data the first time. The 60-day intake compressed to about two weeks at most.

Email back-and-forth eliminated

Every clarification, status check, and correction moved into the system. The data team stopped acting as a human middleware layer between the pipeline and the agency.

Partners can describe pipeline stages without reference material

After two weeks in the system, government-side analysts can talk through where their data is, what's been validated, and what's blocking the next stage, without opening docs.

Data team reclaimed time for the model

With manual conversion and status emails removed, Dan's team shifted from middleware work to research that improves the model. Onboarding additional countries no longer caps on team capacity.

TL;DR

I was brought in on what was framed as a crop detection problem. After mapping the system with the Director of Data, I reframed it as a partnership-scaling problem gated by an invisible validation pipeline, the ML model wasn't eroding trust, the 40-day manual intake process was.

This work sits in the data layer of Agriculture Intelligence, the connected sources section that feeds the platform's crop monitoring, scenario planning, and food security dashboards. The platform's commercial value depends entirely on reliable, country-specific ground truth data. Without a clean, scalable intake process, the platform cannot grow to new crops or new government partners.

Rather than redesign the full ingestion stack, I scoped a read-only MVP that makes the quality pipeline observable: where a submission is, what's happening to it, and what it needs to progress. I produced the service blueprints that got the team aligned on the before/after, negotiated structured error surfaces from engineering, and moved into implementation using a design-directed code generation workflow, shipping reviewable React components alongside the design, not after it.

The problem

The system as it existed

The trust gap wasn't abstract. It was 40 days of manual work, per submission, every time.

External · Government Agency
No visibility, no template, no feedback
  • Submit ground truth manually with no standardised templates or field specifications
  • No mechanism to validate data format or completeness before submission
  • Feedback on data issues comes only after internal review, via manual zoom calls
  • No way to check submission status once data has been sent

Agencies are blind to the status of things.

Handoff gap
No standardised bridge between submission and processing
  • No standardised submission process between agency and internal team
  • Data arrives unpredictably, requiring custom handling per submission
  • No automated validation at point of entry, against the contract or format spec
  • Every new partner, every new crop, every new region restarts the cycle

Every submission is a custom handling job.

Internal · Agriculture Intelligence
Skilled team doing work a system should do
  • Receives contradictory data, missing columns, incorrect values, out-of-scope crops
  • Must manually validate every data point against satellite imagery and spectral signatures
  • Must identify and flag erroneous boundaries (roads, buildings marked as farmland)
  • Must supplement incomplete data from external sources
  • Entire process repeats for every new submission and every new partner

Scaling to new crops or regions means restarting from scratch.

The current state

How the partnership process works today, eight stages of friction

An eye-level read of the eight stages — where Kibet and Dan are at each step, and how a single onboarding stretches across 3–5 months without ever returning a reusable artefact for the next partner.

01 The request
K
D
Day 0
02 Gathering data
K
1 wk later
03 Into the black box
K
D
1 wk later
04 Data cleaning
D
Day 1–40
05 Satellite verification
D
Days–weeks
06 Finding & filling gaps
D
K
Ongoing
07 The back & forth
K
D
Days/cycle
08 Finally ready
K
D
3–5 mo total
Read the full current-state script — eight stages of friction
Current state: fragmented, manual, invisible
KM
Kibet Moses External · Ministry Admin
DL
Dan Letterman Internal · Agriculture Intelligence Data Team
01 The request, partnership kickoff meeting Partnership kickoff

Kibet, a ministry admin at the Ministry of Agriculture, finishes a meeting with the Agriculture Intelligence platform team. They need ground truth data to onboard the country onto the platform.

During the meeting, they discussed field boundaries, crop types, and location data, but the specifics were vague. No one shared a template or defined exactly what formats or fields were required.

Kibet leaves the meeting wanting to get this right. The platform promises real value for the ministry's agricultural programs. But he's not quite sure where to start.

No clear specifications No template or format guidance
02 Gathering the data 1 week later

Kibet gathers all the ground truth data the ministry has collected over the years. It sits in multiple formats, spreadsheets, shapefiles, and PDFs from field officers.

He doesn't know which format the platform needs, so he packages everything together. Some files use local crop type names; he's unsure if they match what the platform expects.

He reviews the data manually, but with thousands of records across multiple regions, he can only spot-check. He hopes it's enough.

No standardised template Inconsistent formats across sources Local naming conventions, unverified
03 The submission, hoping for the best 1 week later

Kibet sends the data to the Agriculture Intelligence team. He feels uncertain, there was no way to validate whether the data was complete or correct before submitting. Now he waits.

There's no way to check submission status or get feedback. He moves on to other work, hoping he won't hear back with a long list of problems.

On the other side, Dan and the data team receive the submission. Dan opens the files and immediately sees the challenge ahead.

No pre-submission validation No status visibility for Kibet Errors caught only at manual review
04 Data cleaning Day 1–40

Dan and the data team begin processing. The files arrive in mixed formats, CSV, shapefiles, scanned documents. Column names vary. Required fields are missing.

They spend at least 40 days converting everything into a standardised format. Then they validate content against the contract, checking crop types, field sizes, coordinates. They find mismatches, local naming conventions, impossible values. Each issue is flagged for manual correction.

40 days of manual conversion per submission Non-repeatable, custom work High manual load for skilled team
05 Verifying against satellite imagery Days–weeks

Dan and the team move into verification. Each record is manually checked against satellite imagery to confirm that what is claimed matches what is on the ground.

They review field boundaries polygon by polygon, checking that recorded farmland isn't actually a road, a building, or a mountain. For an entire country's worth of data, this takes days. The team is skilled at this, but Dan knows their time could be spent on higher-value work. Instead, they're verifying data.

Labor-intensive, non-scalable verification Skilled team time on routine work
06 Finding and filling gaps Ongoing

The team discovers gaps. Entire regions are missing field records. Some crop types have too few samples. They search for external data sources to supplement, some are available; others aren't.

For gaps that can't be filled externally, they go back to Kibet. Kibet receives the request and starts looking. He thought he had sent everything. Now he's digging through records again.

Data gaps require external supplementation Repeated requests back to the agency
07 The back and forth Days per cycle

Kibet sends additional data. The team validates it again, standardising, checking content, verifying against imagery. More questions arise. Another email to Kibet. Another round of waiting. Each exchange adds days.

Neither side has visibility into what's still missing or how close they are to completion.

No real-time visibility for either side Repeated back-and-forth extends timelines Progress is opaque
08 Finally ready 3–5 months total

The ground truth data is finally clean and ready for use. Dan and the team have spent over a month on what should have been a straightforward intake process.

The platform can now deliver value to Kibet's ministry. But when the next partner onboards, or this ministry expands to new crops or regions, the cycle starts again from scratch.

Onboarding is slow and resource-intensive No reuse, every new submission restarts the cycle

The user experience, across both sides of the partnership, collapsed to two sentences:

  • "I upload data and it disappears into a black box." — Kibet
  • "Every submission is a custom handling job." — Dan
Research and insights

What the research surfaced

I was inside the digital government, having conversations with the in-house data team, the Director of Data, and the people who actually ran the data intake. From there, in-person interviews with the ministry admins on the government side — the Kibet-type users — surfaced the partner-side pain the internal team only saw indirectly. The same themes returned across every conversation and every step of the current state. Drag any note around — they live as a pile, not an ordered list, because that's how they came up.

No handoff spec, just meetings

Every onboarding starts with a meeting. No template, no schema doc. Kibet leaves the call and starts guessing what's needed.

A 40-day black box

Once data is submitted, Kibet hears nothing for ~40 days. No status, no progress, no signal it even arrived intact.

No ownership on agency side

After submission, no one inside the partner ministry feels accountable. It becomes Dan's problem to chase down corrections.

Every submission resets the clock

No reuse between rounds. The fifteenth submission costs the team the same hours as the first. Zero compounding learning.

~60 days to onboard one partner

Two months from first call to a clean dataset. Most of that is waiting on documents that nobody flagged were even required.

Communication runs on email threads

No shared status. No queue. No system of record. Every clarification is a new email reply-all that someone has to keep alive.

Skilled people on manual conversion

Dan's team spends days doing format conversion and column renames a script should handle. Senior data work, not data wrangling.

Errors surface late

Validation happens at the end of the pipeline, not at upload. Bad geometry or wrong CRS only fails after the data team has touched it.

"Mundane" work as middleware

The Director's word: the team is acting as middleware between the pipeline and the agency. Manually emailing status updates that should be automatic.

Partner onboarding doesn't scale

The 40-day intake scales linearly with partners. The data team doesn't. Adding the tenth partner means breaking the team.

"Good data" is undefined

Partners can't validate before submitting because nobody has written down what "valid" means. It only emerges after rejection.

Kibet wants visibility, not handholding

"I just want to know it landed and what's happening." The ask isn't fancier UX, it's just a status the partner side can see.

User goals

What users actually need

Two users. Tightly coupled goals. The case for read-only visibility only makes sense when you see their pain as a single coupled system, Kibet can't standardise without specifications, and Dan can't stop doing custom handling until specifications exist and are enforced.

The wall between them is the thing that takes 40 days. Kibet can't standardise without specifications; Dan can't stop custom handling until specifications are enforced.

The future

What a pipeline could look like when friction is engineered out

Four themes kept surfacing in every interview and every step of the current state: no specifications at handoff, no visibility after submission, skilled people doing automatable work, and zero reuse across submissions. None of those are UI problems. They are lifecycle problems, and that changed what I was actually designing.

So I reframed the brief from "redesign the upload flow" to "make the quality pipeline observable and self-service." That reframe changed the unit of design from a form to a lifecycle, the user from a single admin to a partnership, and the measure of success from submission UX to partnership throughput.

Six stages, two decision points. Most steps run on the system; two are deliberately the user's call — that's the design work. Where everything is automated, and where Kibet still needs to step in. The architecture below is what we converged on with the Director of Data and Director of Product: the partner-facing surface is the read-only window into this pipeline.

Before 40-day partner onboarding waits
After Minutes to format check · hours to quality · days to first detection result

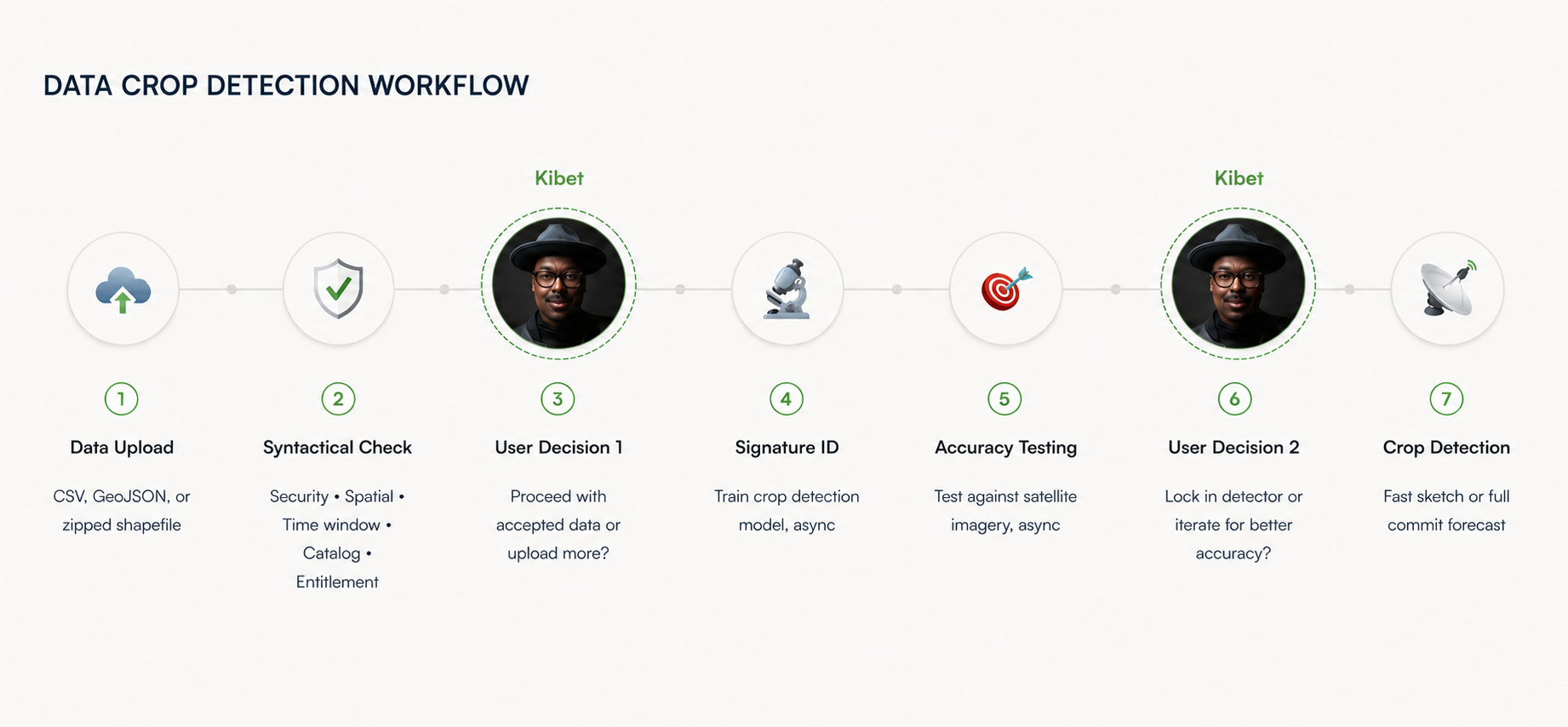

Quality pipeline diagram, six stages and two decision points, from data upload through syntactical check, decision one, signature ID, accuracy testing, decision two, to crop detection
01 Clear specs day one
K
Day 1
02 Format check, immediate feedback
K
Same day
03 Quality check passes
K
Day 2
04 Baseline accuracy
K
Same week
05 Full-scale detection
K
Same week
06 Dan reclaims time
D
Ongoing
View the full future-state script — six stages of self-service
Target state: from submission to detection, self-service
KM
Kibet Moses External · Ministry Admin
DL
Dan Letterman Internal · Agriculture Intelligence Data Team
01 After onboarding, clear specifications from day one Day 1

After contract close and as part of onboarding, Kibet receives access credentials for Agriculture Intelligence. He logs in and is guided to the ground truth admin area, where he sees a clear overview of the ground truthing process.

He also sees the precise data requirements he needs to meet. Using those requirements, he prepares the crop data and uploads.

User always knows what's required before beginning
02 Data format check, immediate, specific feedback Same day

In the background, the system runs a security scan on the file first, then checks the data format. Kibet can see the status of what is happening and receives precise feedback.

a) If data passes, he gets confirmation of acceptance and knows his work is done for now. b) If not, he sees exactly what to fix, making corrections and re-uploading as needed. No guessing, no delays.

Success is unambiguously defined and consistently enforced Problems are actionable and transparent, not generic
03 Data quality, precise failure vocabulary Day 2

After format is accepted, the system continues into data quality check. Kibet can see the workflow has moved into data quality. a) If the data quality checks out, the system moves on. b) If there's a problem, the system flags it, Kibet sees exactly which crop or region needs more data or where corrections are required. Instructions are clear, actionable, and free of jargon.

All actionable issues surfaced accurately and automatically External users focus only on what they need to fix, no internal QA exposure
04 Baseline detection & accuracy testing Same week

The system moves into baseline detection. Once the unique spectral signature of the crop is identified, the system runs testing and produces an accuracy result. Kibet receives the result and reviews.

a) If the results satisfy Kibet, he gives the go-ahead for full scale detection. b) If not, the workflow shifts into improvement, adding more input data or Dan refining the detection model, then rerunning.

Continuous automated feedback, Kibet always in the loop
05 Full scale detection Same week

After approval, the system kicks off full scale detection and yield/production forecasting. Optional: if needed, Kibet can still upload additional data to improve accuracy over time.

At any point it's clear which crops are done, what's in progress, how much longer
06 Internal view, Dan reclaims time Ongoing

Dan Letterman is not involved in the routine workflow anymore. Because routine work is handled through the process, he spends most of his time improving the model and performance, and only steps in when needed.

Data team time freed for high-value model improvement Routine intake no longer requires expert intervention

What previously required weeks of fragmented manual work is now:

  • minutes to format check
  • hours to quality validation
  • days to first detection result

The shift is not speed alone. It is clarity, confidence, and continuity for both sides of the partnership.

Design decisions

Clarity over density, designing for a ministry admin, not a data analyst

The design goal is clarity across levels: what's happening across the board, where the system is, where the user doesn't need to step in, and where they do. Kibet is a ministry admin, not a data analyst, every trade-off resolves toward clarity over density.

A scannable submission table

A submission is tied to one crop, so the table is really a view of crops in flight. The work was in simplification, stripping it down to what matters: which crop, which version, is it active or inactive, is it processing, where does the user need to act.

The "needs action" surfacing carries the two user decision points as first-class items, not buried sub-states. Users filter quickly to the rows that need them; everything else lives behind the row.

A drawer for detail

V1 is read-only, so navigating to a detail page is wasted motion. Opening a submission in a drawer keeps the list in context and lets users compare without losing their place.

Entitlement surfacing

Locked-in crops count against a contract cap (e.g., 8 crops). The UI surfaces crops remaining up front, because that number directly shapes whether a user locks in a noisy detector or iterates for a better one. It's a small element doing outsized work.

The engineering negotiation

I refused to ship generic "validation failed" states. Each gate in the pipeline, spatial validity, time window, crop catalog, signature quality, needs its own failure vocabulary in the UI, because the user's next action differs. A spatial failure means "check which polygons fell outside your country boundary"; a crop catalog failure means "your local crop name doesn't match our approved catalog." This required engineering to return structured error data rather than human-readable strings.

Why it matters A user seeing "validation failed" learns nothing. A user seeing "3 polygons flagged as non-agricultural area, check field boundaries in Rift Valley region" can act immediately. The grammar of failure states is the grammar of self-service.
Success criteria

How the work landed against the bar I set

Three axes were set before design began. Here is how each played out — what the work delivered against each measure.

01
Partner throughput

Partner onboarding time compressed materially, from a 3–5 month cycle toward something the data team can sustain as partnerships scale.

02
External self-service

Kibet, the ministry admin, can diagnose and resolve data issues without opening a support thread.

03
Internal time recovery

Dan, the data team lead, stops owning routine format conversion and manual verification, and reclaims time for model improvement.

Building with AI

How AI is expanding my role — from design into front-end

Design → Engineering

AI is letting me extend the design role into front-end implementation. I no longer hand off static mocks; I ship reviewable React components alongside the design, not after it. Three phases, each using AI at a different level of fidelity — wireframing for breadth, design-system reconciliation for honesty, code generation for handoff.

Phase 1, Figma Make → Figma → Figma Make
Rapid intent-to-wireframe loop

Before touching the design system, I write out what the UI needs to expose and what decisions a user faces. I take that into Figma Make and generate wireframe directions, then pull the output into a Figma file, adjust what's wrong by hand, and feed the refined version back through Figma Make. The loop runs until the flow feels right. AI for breadth and speed; Figma for precision where generation oversimplifies.

Compressed wireframing from days to hours. The value isn't in any single frame, it's in how many directions the loop lets me discard quickly.

↳ Figma Make prompt → generated wireframe → hand-refined version.

Phase 2, Design system
Reconciling exploration with production constraints

Once the exploration loop settles on a direction, I move into the existing Oracle design system. This is deliberately unglamorous: which tokens exist, which components can be composed into what I need, what has to be net-new. Fast-and-loose wireframes become production-grounded. Every component decision made here becomes the handoff spec, including what I'm asking engineering to build vs. what already exists.

The design system pass is where speed meets honesty. It tells me, before engineering is involved, what's actually buildable in the current sprint.

Wireframe mapped against the Oracle design system: tokens and components reconciled

↳ Wireframe mapped against Oracle design system tokens and components.

Phase 3, Codex + React
Expanding into front-end implementation

The reconciled design moves into Codex to generate React components against our existing component library. I treat the output the way I'd treat a junior designer's first draft, checking whether state coverage is exhaustive, whether hierarchy reflects user priorities, whether the generated component would survive real data. I've built reusable prompt scaffolds encoding the state vocabulary, design tokens, and error grammar, so the third component inherits everything the first learned.

Engineering receives something that already works. Their job becomes integration, not reconstruction, and the UI back-and-forth that usually happens in review collapses substantially.

↳ Codex prompt + generated React component output side-by-side.

Reflection

What this work is really about

This isn't a crop detection UI. It's the quality gate that determines whether the platform can scale partnerships at all. Today, every new government partner costs the data team a month of manual work, and every expansion restarts the cycle. The MVP attacks the three things that make that cycle expensive:

Working on this also pulled me, as a designer, into territory I hadn't owned before, service architecture, data pipelines, validation gates, engineering negotiation. What I learned is that the strongest design work in a complex system is rarely about the surface. It's about understanding where the friction actually lives, often somewhere you can't see from the UI, in a handoff between two teams or a missing decision-rights boundary, and designing for that. By the time the design took its final shape, most of the work had already happened in conversations about what the data team would auto-validate, what engineering would gate, and what the partner ministries could be trusted to standardise. UX work that stops at the screen leaves the hardest problems untouched.

The goal was never to make the upload UI nicer. It was to make the pipeline honest about what it's doing and who it's waiting on.

Parent project Making sense of agriculture Next project Artificial intelligence for agriculture
